Maidenhead, Windsor
      & Eton Flood Alleviation Scheme
      Background Notes
      (Pre-Construction)
      1. Introduction
      The towns of Maidenhead, Windsor and Eton
      and nearby villages have a very long history of flooding from
      the river Thames. The threat still exists. Flooding will occur
      again and again in this area unless some scheme of alleviation
      is implemented.
      2. Last Major Flood
      This area floods about once in five to
      seven years and there was a flood of this magnitude in 1990,
      which affected around 500 homes. The last major flood occurred
      in 1947 and had a return period of 1 in 56 years. If a flood
      of this size were to happen today it is estimated that over 5,500
      properties (and consequently over 12,500 people) would be affected
      at a cost of £40 million.
      The major roads in this area, including
      the M4, would be closed and electricity, telephone and other
      services would be interrupted. This would affect countless other
      people and would have an adverse effect on the local economy.
      Which in turn would affect the national economy.
      3. History of The Scheme
      Thames Conservancy
      After the 1947 flood, there was a lot of
      public pressure on the relevant authorities to do something to
      stop a similar flood happening. The Thames Conservancy was the
      relevant authority at that time, and they investigated the problem
      and produced a summary report. The Chief Engineer of the Conservancy
      recommended to the Board that planned zones should be established
      along the length of the river in which new development should
      be prohibited and existing development be demolished when it
      came for sale.
      These recommendations were accepted and
      the local planning authorities took
      appropriate action by amending their County Plans. In December
      1954 Maidenhead flooded again. This time it was as a result of
      the Maidenhead Ditch overflowing and not the river Thames. The
      Conservancy decided to undertake flood alleviation works in this
      area by increasing the capacity of both the Maidenhead Ditch
      and The Cut. They also reconstructed a bridge north of the Maidenhead
      Ditch so that when the flow in the Maidenhead Ditch reached its
      capacity, the bridge would restrict any more incoming flows and
      store excess water in a pond area in North Town Moor.
      These works which have a capacity for a
      one in ten year return period flood were intended to stop a repeat
      of the 1954 flood only, and were not undertaken to solve the
      overall flooding problem in Maidenhead.
      Thames Water Authority
      In 1973 when the Water Authorities were
      formed, they were required by law to
      undertake surveys in respect of flooding and land drainage. From
      these surveys, the Maidenhead flooding problems were identified
      and strategies developed for possible solutions.
      There are flooding problems along the whole
      length of the river Thames, but it was considered impossible
      to solve the problems along the whole length in one go. The Maidenhead
      area was identified as needing priority action because of its
      history of repeated flooding and where money spent would produce
      the greatest return in damage avoided.
      Thames Water Authority appointed a specialist
      firm of consultants to investigate the flooding problem and also
      what would be the likely benefits of various options of flood
      alleviation schemes. They identified that there would be considerable
      benefits if the flood damage could be avoided and that it would
      be possible to alleviate flooding in this area.
      Following this report, consultants working
      on behalf of Thames Water Authority undertook exhaustive studies
      of the complex and interrelated engineering and environmental
      considerations of various flood alleviation schemes. Local authorities
      and other interested organisations and individuals were consulted
      extensively and their responses were taken into account. All
      possible options were considered so that the scheme chosen was
      the most appropriate method of meeting flood alleviation in this
      area.
      In January 1989, the Thames Regional Land
      Drainage Committee agreed to seek planning permission for the
      Scheme chosen and in March 1989 they agreed To extend the Scheme
      to provide flood protection for Windsor and Eton, and not just
      Maidenhead.
      National Rivers Authority
      The National Rivers Authority took over
      the work of Thames Water Authority when it was formed in September
      1989 and continued to investigate and develop the Scheme.
      The present Project Team was appointed
      in September 1989 with a brief to obtain planning permission
      by negotiation, if possible. Unfortunately it was not possible
      and a local Public Inquiry was set up in 1992.
      The Scheme finally received approval from
      the Secretary of State in 1995,
      Environment Agency
      The Environment Agency is the statutory
      successor to the National River Authority, Waste Regulation Authorities
      and Her Majesty's Inspectorate pollution. The Agency has inherited
      all flood defence duties from the National Rivers Authority and
      this includes constriction of the Maidenhead, Windsor and Eton
      Flood Alleviation Scheme.
      4. Options Considered
      All methods of flood relief were considered
      including storage, dredging and embankments before it was decided
      that the best option was to construct a Flood Relief Channel.
      Over 492 possible combinations of routes were examined and evaluated,
      and local authorities and other interested organisations and
      individuals were consulted, and eventually the present route
      and design were adopted.
      The channel solution was selected on the
      basis of providing a minimum protection for the area of I in
      65 years flood event standard. At this level of protection the
      other possible options of flood alleviation were not practicable
      for various reasons: flood storage schemes would have needed
      an area the size of Oxfordshire to accommodate all the water;
      large flood levees along the edge of the river would not have
      been possible environmentally; dredging would have been disruptive
      and would have to be done continuously to maintain the required
      capacity.
      5. Scheme Description

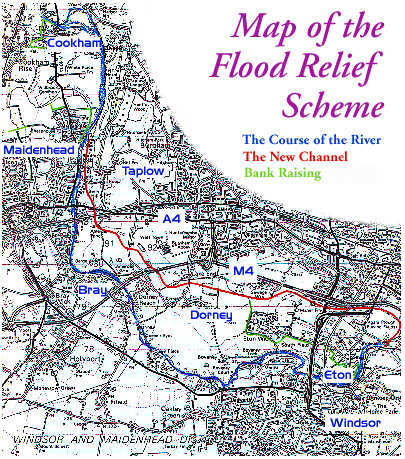

      The Scheme takes the form of a flood relief
      channel, some localised bank raising close to the river and improvements
      to the existing flood relief channel, through Maidenhead, The
      Maidenhead Ditch.
      The channel runs along the east side of
      the river Thames, leaving the river at Boulter's Weir in North
      Maidenhead and rejoining at Black Potts Viaduct just downstream
      of Windsor, It has a trapezoidal cross-section that is unlined
      with a bottom width of about 30 m. The side slopes are 1 in 1.5
      and average depth is 5 m so that for most of the route the channel
      is 45 m wide.
      Natural Design
      The channel has been designed to look and
      function as a natural living river, containing water all year
      round, and will be landscaped sensitively to enhance the environment
      and create new habitats in what is currently a relatively ecologically
      uninteresting area. The Environment Agency will also recreate
      habitats that have been lost from the river Thames over the years,
      as a result of river-side developments.
      As a consequence of the high emphasis placed
      on environmental design, the Scheme has gained support from both
      national and local environmental groups.
      Operation Under Flood
      Conditions
      The river Thames in this area can accommodate
      a flow of about 285 m3/s. Above this level the excess water will
      overflow the banks and fill the flood plain.
      The channel takes the excess water flow
      from the river Thames. The amount of water allowed down the channel
      will be controlled by radial gates near Taplow Mill.
      The channel and the river Thames together
      will be able to accommodate a flow of about 515m3/s with the
      Flood Relief Channel carrying 215m3/s. This will protect the
      area from floods with a return period of I in 65 year period,
      a greater intensity than the 1947 flood. It will also substantially
      reduce the impact of greater events.
      Normal Operating Conditions
      The channel will have running water all
      year round. The water will be supplied naturally from the ground
      water table and a small flow of about 10 m3/s taken directly
      from the river Thames.
      Water levels within the channel will be
      regulated by control structures and these will be set at a level
      to ensure that existing ground water levels are maintained within
      the area.
      6. Public Inquiry
      Because of the regional significance of
      the Scheme, and the inability of one of the local councils to
      resolve the matter, the planning application was called for Public
      Inquiry in 1992.
      The Inquiry opened on 1 October 1992 and
      closed at the end of December 1992. Even so it was not until
      March 1995 that approval was finally given.
      Inquiry Assessor's Recommendation to the
      Secretary of State:
      "My overall conclusion is that the Scheme described in the
      Planning Application is a good technical solution to the flooding
      problem which no other option can match".
      The Inquiry Inspector stated:
      "Furthermore, I find that the evidence strongly suggests
      that the Scheme would be a uniquely attractive addition to the
      landscape between Maidenhead and Windsor.

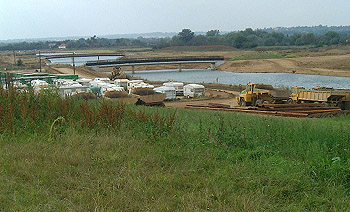

      7. Soil Disposal
      Whilst the finished Channel will be a quiet
      and pleasant addition to the local scene, its construction will
      cause considerable local disturbance for a limited period of
      time. The major challenge will be the removal of excavated material,
      principally minerals, from the site. The majority of this material
      will be taken directly along the line of the channel to a processing
      plant and then on to the M4 Motorway via Junction 6; material
      from the two end sections will be removed by barges on the Thames.
      This will avoid any use of local roads for other than construction
      traffic to specific sites.
      Since the granting of the Planning Approval
      the minerals industry has been working hard to find ways of accommodating
      3.5 million tonnes of mineral from Maidenhead in 31/2 years whilst
      at the same time Eton College are producing 4.5 million tonnes
      over a period of 11 years into a contracted market which is already
      fully supplied.
      Many of the solutions allow for long term
      storage of material and various potential contractors have obtained
      planning permission on various sites for importation and storage.
      There is planning permission to install
      a rail siding on the site of the gravel processing plant and
      permission for a conveyor to bring mineral from Area Nine to
      the rail terminal.
      This option is strongly favoured on environmental
      grounds and carries the possibility of receiving a Government
      Grant to enable the environmental benefits to be realised in
      the face of possibly adverse financial factors.
      Sale of the minerals will go some way to
      offset the cost of constructing the channel although the Treasury
      have insisted it is not an economic gain and all reference to
      the sale of minerals has been omitted from the benefit/cost assessment
      approved by them.
      8. Cost
      The estimated gross implementation cost
      of the Scheme is £83.5M including a projection of inflation
      at 3% to the end of the construction period. This sum will be
      offset by money arising from the sale of minerals. The Scheme
      is designed to alleviate flooding of some 4,800 private properties,
      benefiting some 12,500 people, 700 commercial premises and major
      infrastructure - for example the M4 - that would be at risk.
      Benefit/Cost Analysis
      The estimated gross implementation cost
      of the Scheme is £83.5M including a projection of inflation
      at 3% to the end of the construction period. This sum will be
      offset by money arising from the sale of minerals. The Scheme
      is designed to alleviate flooding of some 4,800 private properties,
      benefiting some 12,500 people, 700 commercial premises and major
      infrastructure - for example the M4 - that would be at risk.
      The tangible benefits arising from the
      Scheme, discounted at 6% to 1992, are £52.728 million.
      The implementation and maintenance costs
      of the Scheme over its designed life of 65 years, again discounted
      to 1992, are £43.738 million.
      Thus the Benefit/Cost Ratio is 1.21:1
      When intangible benefits are added at 25%
      the figure becomes 1.4:1
      This very robust figure has been accepted
      by the Ministry of Agriculture, Fisheries and Food but the inclusion
      of recreation and amenity benefits and benefits from the sale
      o minerals has been disputed by the Treasury. Nonetheless, even
      with these excluded the ration is 1.07:1 which is just about
      satisfactory.
      |
